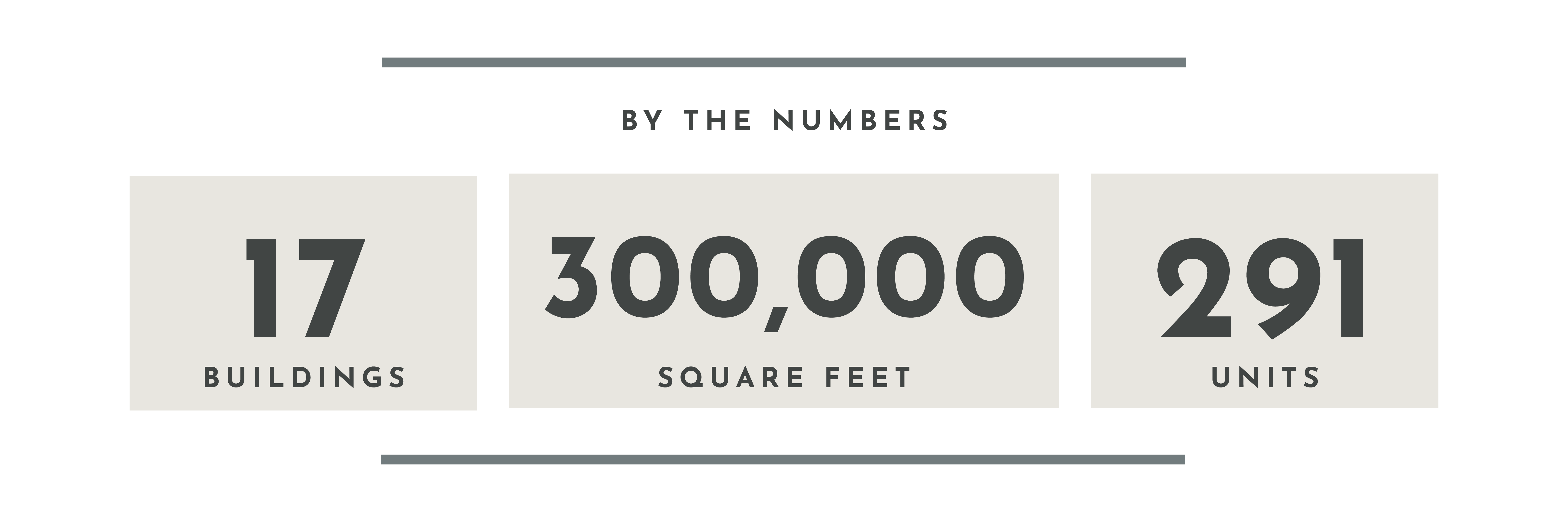

Building Your New Home
We are excited to share updated and timeline event markers to the completion of our brand new property. See below for more information and don't forget to reserve your spot today!

Construction Timeline

AUGUST 2025

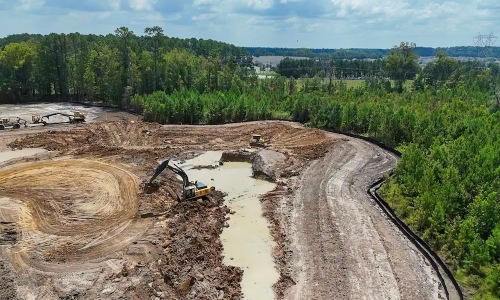

Groundbreaking
• Permitting complete
• Lot cleared and site prepared
JANUARY 2026
Foundational work
• Concrete poured — Clubhouse
• Concrete poured — Buildings 1000, 2000, 4000, 5000 & 6000
FEBRUARY 2026
Framing begins & townhome foundations
• Clubhouse framing in progress
• Framing in progress — Buildings 1000, 2000, 4000 & 5000
• Concrete poured for townhome foundations
MARCH 2026
Framing continues
• Clubhouse fully framed

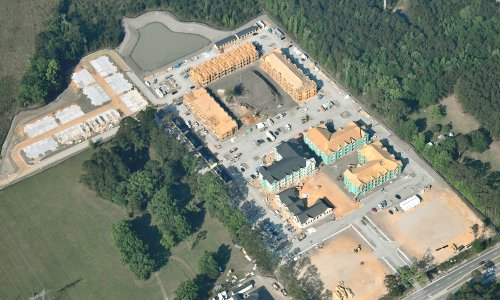

APRIL 2026
First roof installations
• Roof installed — Clubhouse & Building 1000
• Buildings 2000 & 3000 fully framed
• Framing begun on townhomes
JULY 2026
Clubhouse windows & interior finished

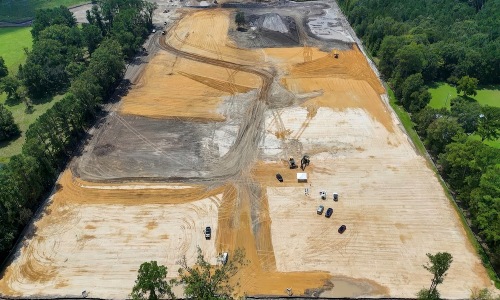

AUGUST 2026
Clubhouse FF&E installation
• Pre-leasing anticipated Aug 1
• Furniture, fixtures & equipment installed in clubhouse
SEPTEMBER 2026
Clubhouse & pool completion
• Expected completion and acceptance of clubhouse
• Pool complete
OCTOBER 2026
First homes delivered
• Building 1000 — first apartment homes anticipated completion
• Building 7000 — first townhomes anticipated completion
JANURARY 2027
Completion of all buildings
